Project report · Every two months
Project report: 25 October 2026
Drikung Kagyu Monastic School. Phase 1A dormitory and Phase 1B classrooms.
1Project summary
The construction of the monastery’s new dormitory and classrooms began on 28 August 2026. The project aims to improve residential and educational facilities for the young monks. Fundraising and construction work are ongoing.
2Construction progress
| Area | Current status | Work completed this period |
|---|---|---|
| Phase 1A dormitory | Underway | Construction of structural pillars, walls and window frames. Pouring of the roof slab (lenter) has started. |
| Phase 1B classrooms | Not started | Not started yet. The site is being used as the current dormitory. |
Delays or changes: none.
3Next two months
- Planned work
- Building of the roof slab and curing (hardening) it with water.
- Expected milestone
- Roof slab structure built and cured, with related works, expected to be complete by 25 December 2026.
4Fundraising position
| Approved Phase 1 goal | INR 1,27,40,464 |
| Phase 1A | INR 70,57,556 |
| Phase 1B | INR 56,82,908 |
| Total contributions toward the goal | INR 26,88,938 |
| Still needed | INR 1,00,51,526 |
5Financial summary in INR
Movement during this period
| Item | Amount (INR) |
|---|---|
| Opening project funds | 26,64,272 |
| Add donations received through Ketto | 0 |
| Add other project receipts | 0 |
| Less platform and payment fees | 0 |
| Less donor refunds | 0 |
| Less project expenditure paid | 20,00,000 |
| Closing project funds | 6,64,272 |
Where closing funds are held
| Project bank and cash balances | INR 6,64,272 |
| Held by Ketto and not yet settled | INR 24,666 |
Spending by category
| Category | This period (INR) | To date (INR) |
|---|---|---|
| Materials and structural work | 19,27,139 | 19,27,139 |
| Labour and transport | 4,01,400 | 4,01,400 |
| Contractor or management allowance | Nil (not invoiced yet) | Nil (not invoiced yet) |
| Total project expenditure to date | 23,28,539 | 23,28,539 |
| Total paid to date | 20,00,000 | 20,00,000 |
| Unpaid invoices | 3,28,539 | 3,28,539 |
Unpaid invoices or committed costs. To date, the organization has paid INR 20,00,000 (twenty lakh rupees) to the assigned contractor. Bills amounting to INR 23,28,539 (twenty-three lakh, twenty-eight thousand, five hundred and thirty-nine rupees) have been received for the project so far. The outstanding unpaid invoice amount is therefore INR 3,28,539 (three lakh, twenty-eight thousand, five hundred and thirty-nine rupees).

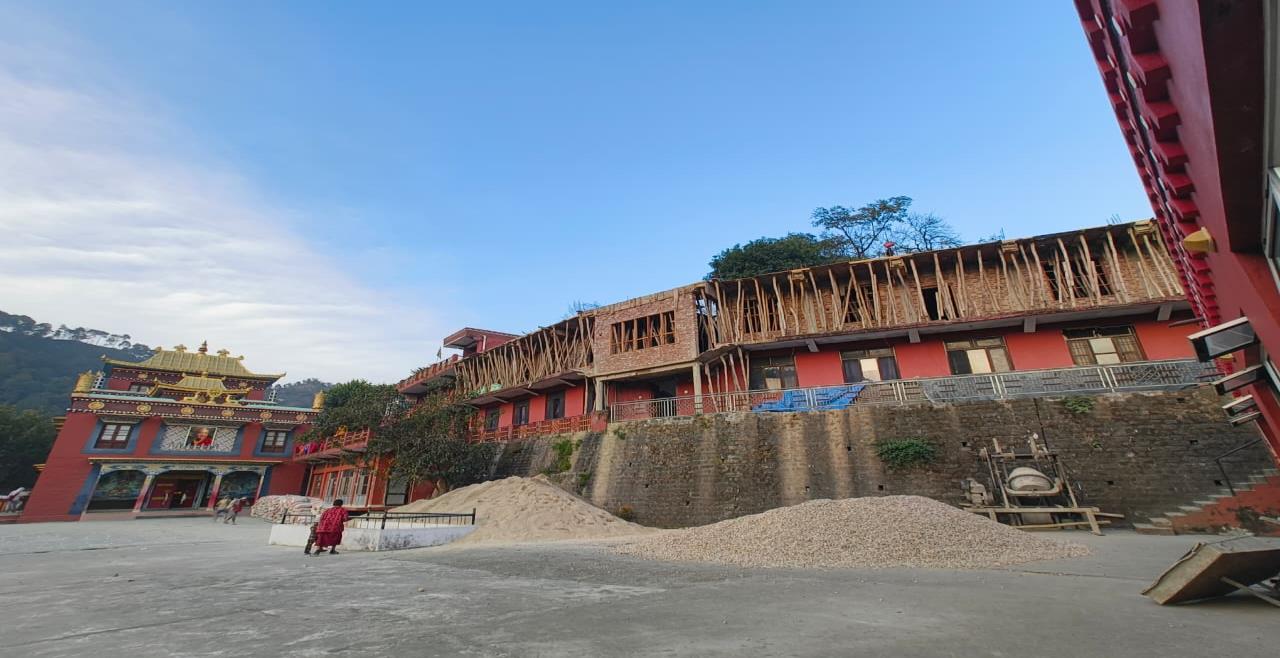

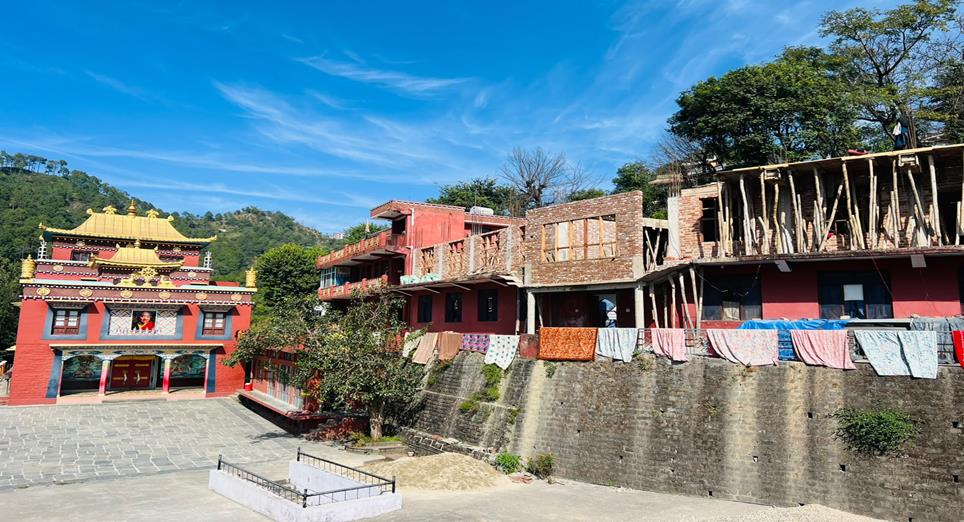

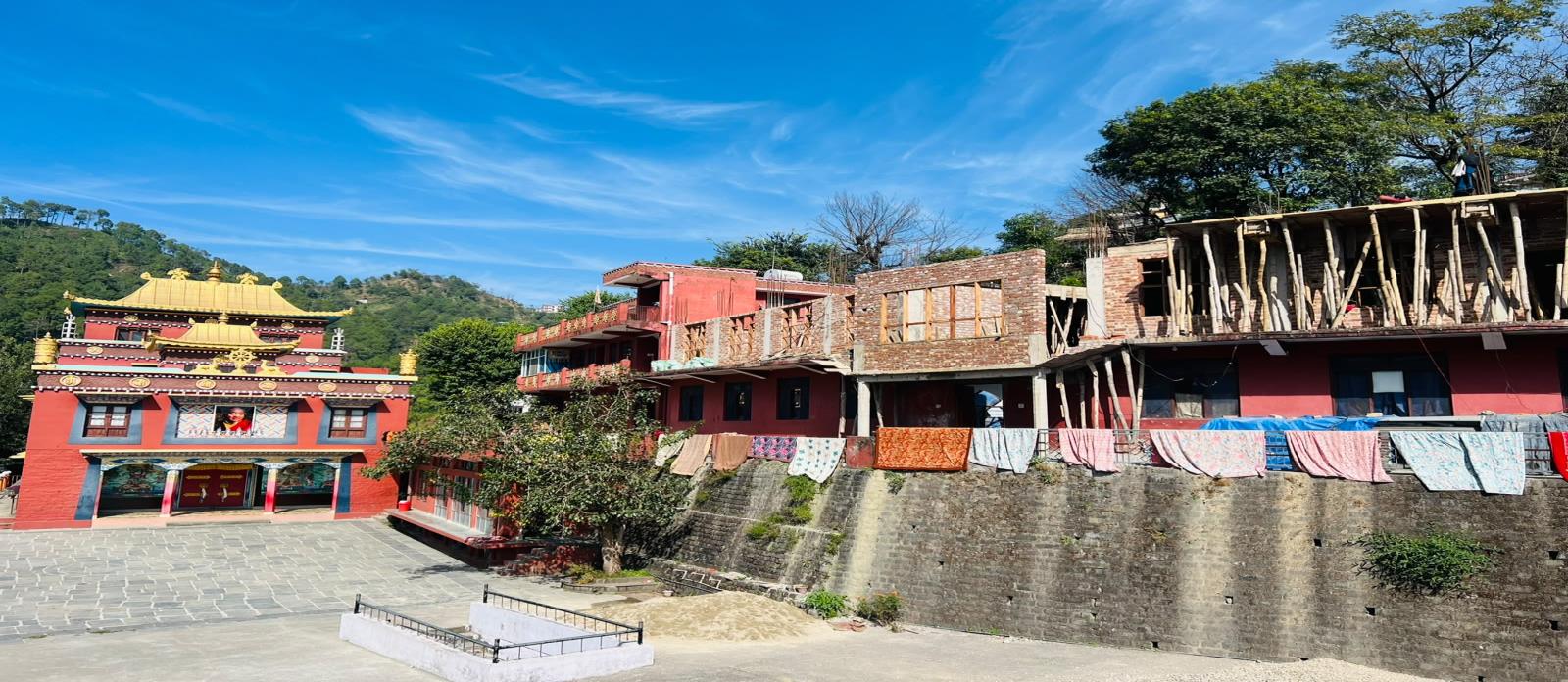

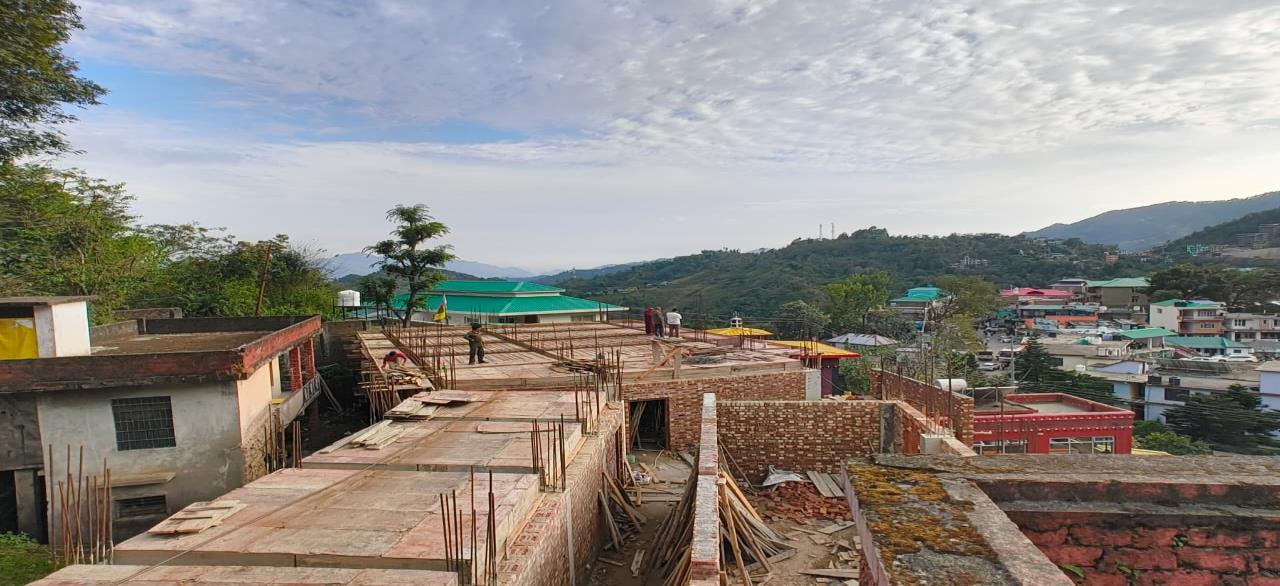

6Dated construction photographs




7Approval and publication
- Construction reviewed by
- Ven. Konchok Lekden
- Finances reviewed by
- Tenzin Yangdon
- Approved for publication by
- Sonam Choedon
- Next report due
- 25 December 2026
- Contacts
- Coordination: Tenzin Dawa Lhundup. Financial reporting: Tenzin Yangdon. Public enquiries: wtsl1971@gmail.com
